Skip to content

Bribie Island emergency works

The Queensland Government has directed the Coordinator-General to undertake emergency works to address the southern breakthroughs and buffering of Bribie Island to enhance protection of Golden Beach and the Pumicestone Passage during the upcoming storm season.

These works are informed by independent expert recommendations and community feedback gathered during recent consultation.

Emergency works scope

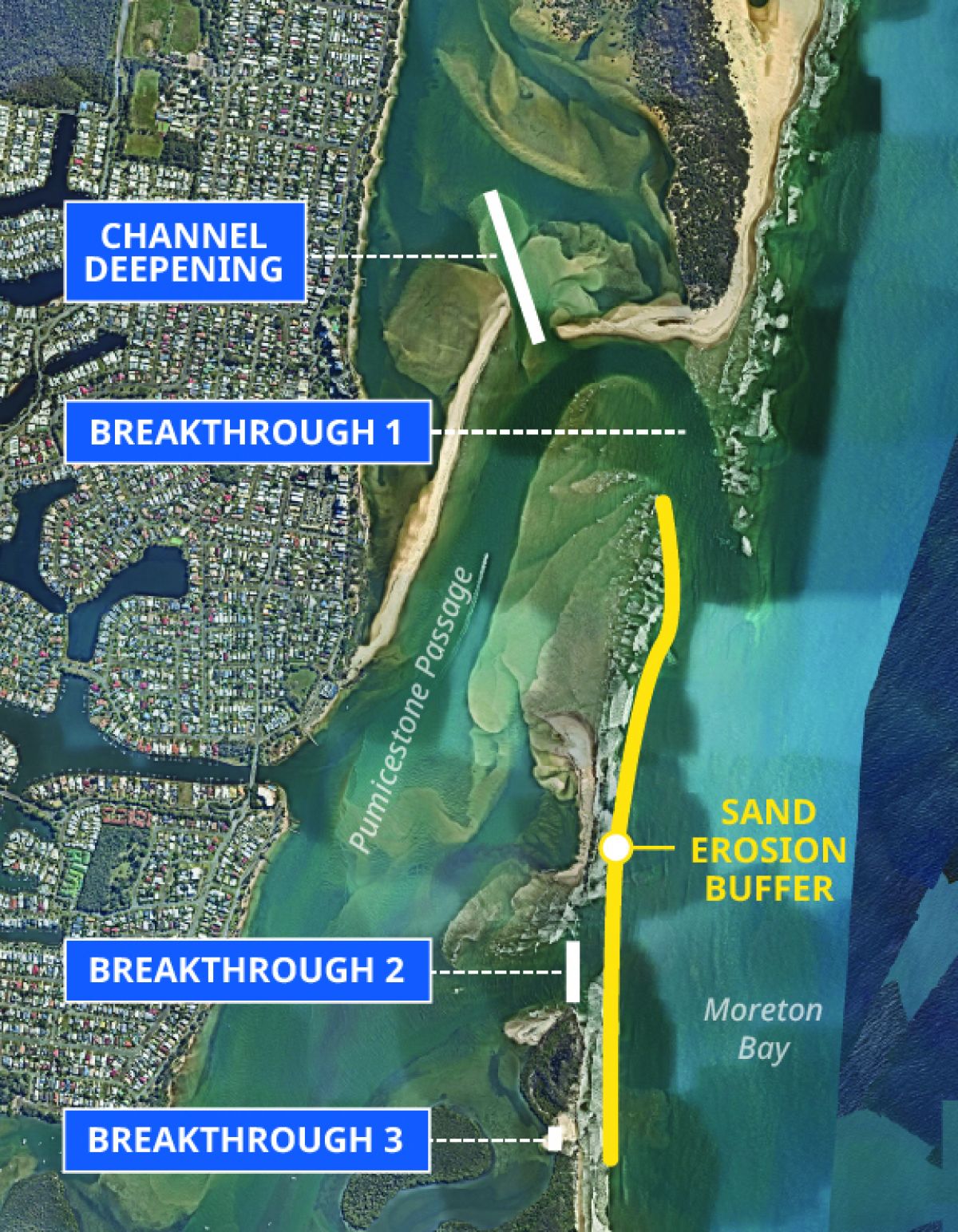

The Bribie Island emergency works involves:

  • closing and stabilising Breakthroughs #2 and #3
  • renourishing and buffering the Bribie Island segment between the Breakthrough #3 and #1, the current tidal entrance to Pumicestone Passage
  • creating a channel between the northern end of Pumicestone Passage and the tidal entrance.

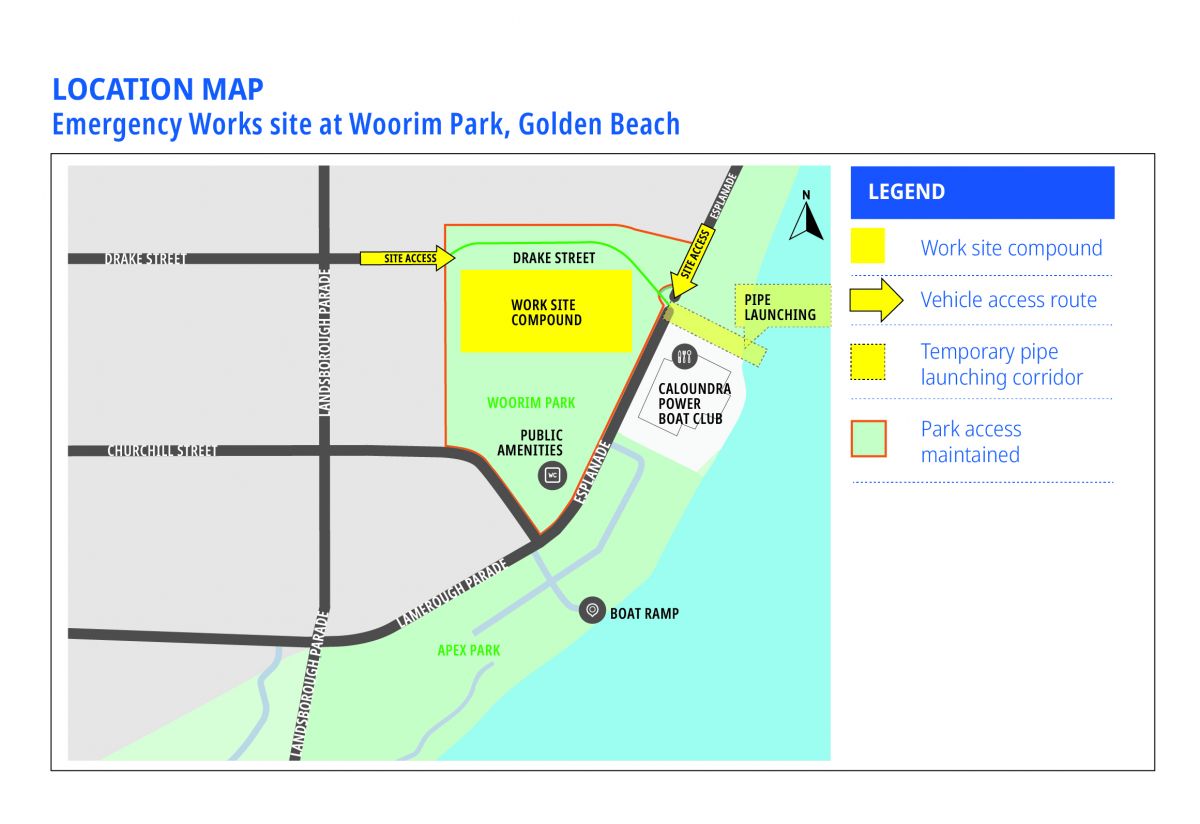

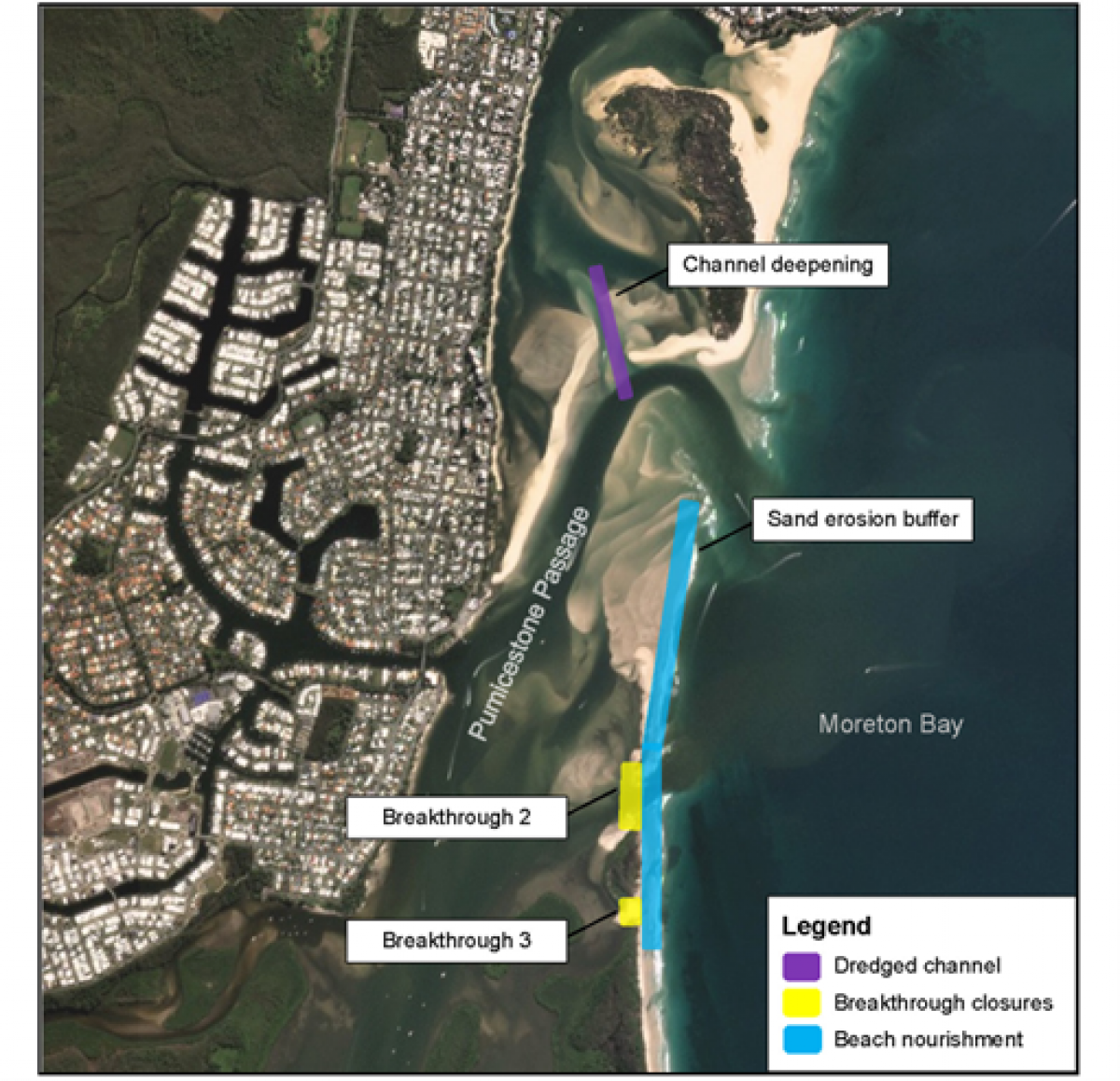

Map of emergency works priorities

Project timings

  • Site established: 29 August 2025
  • Dredging commenced: 27 September 2025
  • Breakthrough #2 closure: 13 November 2025
  • Emergency works completion: April 2026

Project update

Breakthrough #2 was successfully closed on 13 November 2025 to help strengthen protection for Golden Beach and the Pumicestone Passage marine environment for the storm season. The focus is now on closure of Breakthrough #3.

The next step will be for large volumes of sand to be placed along the shoreline of Breakthrough #1 to widen the beach and enhance protection against further erosion. An additional dredger will be introduced to assist this program of works.

The channel to the northern end of Pumicestone Passage will also be deepened to enhance water circulation, water quality and navigational access for mariners.

Note that re-opening the Caloundra Bar at Happy Valley is not part of the emergency works scope.

Longer-term actions

The Queensland Government has considered the recommendations of the independent review of the Bribie Island Erosion and Breakthrough Events.

The Coordinator-General has been asked by government to lead the investigation and implementation of the recommendations for longer-term solutions. While remaining focused on completing the emergency works, the Office of the Coordinator General has commenced planning to assess the longer-term options.

Safety reminder for waterway users

Recreational craft must stay clear of the dredger and all operational areas, including sand stockpiles. This is essential for public safety and to allow works to proceed without interruption.

Community notifications and project updates

Looking for alternative off-leash dog parks?

Subscribe

Want to stay informed about the progress of the Bribie Island erosion and breakthrough? Subscribe now to receive updates directly to your inbox.

For more information

Contact the Bribie Island Emergency Works project team:

E: bribieisres@coordinatorgeneral.qld.gov.au
T: 1800 316 378 (Monday to Friday, 8.30am-5pm)

Frequently asked questions

  • The Bribie Island Emergency Works aim to address the significant environmental challenges caused by breakthroughs along Bribie Island resulting from recent cyclone activity, which has threatened coastal communities, the stability of the island and Pumicestone Passage.

    The works are focused on closing the two southern breakthroughs, buffering Bribie Island to enhance protection of Golden Beach and the Pumicestone Passage marine environment, and improving access and water flows to the northern section of the Passage.

    Undertaking the emergency works now creates time to plan for longer-term strategies and solutions.

  • The emergency works will:

    • stabilise Bribie Island to reduce risk of storm damage to private property, essential community infrastructure and areas of natural and cultural significance within the Pumicestone Passage area, including Ramsar-listed wetland
    • support the health of the Pumicestone Passage by ensuring proper tidal flow and sediment management
    • provide increased resilience to future weather events by reinstating a physical barrier at Bribie Island and reducing the risk of further environmental damage.
  • The purpose of the emergency works is to provide immediate protection for the Pumicestone Passage and Golden Beach coastline whilst long-term solutions are investigated and developed.

    The design and scope for the immediate emergency works were informed by independent expert advice and include design principles to a one-in-10-year storm event.

    If a significant weather event occurred without the emergency works intervention, additional erosion would further degrade the island, widening the breakthroughs. This would pose a significant risk to private property, essential community infrastructure and areas of natural and cultural significance within Pumicestone Passage, as well as ecological values throughout the Moreton Bay Marine Park region and associated Ramsar-listed wetland.

  • The Queensland Government approved a works regulation directing the Coordinator-General to undertake the Bribie Island Emergency works and enliven powers under the State Development and Public Works Organisation Act 1971.

    The works regulation authorises the Coordinator-General to undertake emergency works in, on, over, through or across the foreshore of Bribie Island, Caloundra, Golden Beach or Pelican Waters, or on land laying under the waters of Moreton Bay, including the taking of various types of material from those places for use in the works. Additionally, these powers relevantly include power to enter and occupy land for the purposes of the works, for example to establish compounds for equipment laydown, stockpiling and contractor facilities.

    In practice, this allows the Coordinator-General to work in the foreshore or submerged land and take sand from the Pumicestone Passage and the designated offshore areas.

    The Australian Minister for the Environment and Water determined that it is in the national interest to grant an exemption for the emergency works from provisions of the Environment Protection and Biodiversity Conservation Act 1999. The reasons for the decision are available on the website of the Commonwealth Department of Climate Change, Energy, the Environment and Water.

  • In response the Breakthroughs, the Queensland Government commissioned an independent expert review to investigate the ongoing erosion and breakthrough events and their impacts on Bribie Island.

    On 12 June 2025, RPS and ICM issued the Review’s Part 2 report to the State, which outlined the issues and recommended immediate options in response to the Breakthroughs. The Part 2 Report recommended four immediate actions:

    1. closure of Breakthroughs 2 and 3
    2. buffering of the remaining island segment between Breakthroughs 1 and 2
    3. further buffering of the island or construction of an inner sandbank inside Breakthrough 1
    4. dredging of a temporary channel, linking Breakthrough 1 to the northern passage.

    The Report considered these urgent recommendations qualified as ‘emergency works’ given the situation.

    In response to the findings and recommendations of the Review, on 26 June 2025, the Queensland Government announced funding for the rapid deployment of immediate and urgent works to remediate erosion impacts caused by the Breakthroughs and undertaking resilience works to reinstate features to mitigate against further degradation.

  • You can read the Queensland Government’s response to the recommendations of the independent review of the Bribie Island Erosion and Breakthrough Events along with all four reports.

    The government has asked the Coordinator-General to lead the investigation and implementation of the recommendations for longer-term solutions for Bribie Island. While remaining focused on completing the emergency works, the Office of the Coordinator-General has commenced planning to assess the longer-term options.

  • Re-opening the Caloundra Bar at Happy Valley is not included in the immediate emergency works scope program.

    To improve water circulation, water quality and navigational access for mariners at the northern end of Pumicestone Passage nearest Caloundra, channel deepening works will be undertaken at the tidal entrance at Breakthrough #1.

  • Vegetation planting on the reclaimed sand dunes is a fundamental part of the emergency works. Planting atop of newly placed sand will help to stabilise the dunes by trapping sand, reducing wind speed and binding sub-surface materials with their roots. Detailed design is underway for implementation once beach nourishment is complete.
